Client

BAM Nuttall

Value

£190,000

Sectors & Services

Marine Structures Concrete Repair Coatings Corrosion Control Cleaning & Preparation Projects

Centenary Quay in Southampton was constructed in 1962 as part of the city’s historic shipbuilding infrastructure and played a key role in supporting the operations of Vosper Thornycroft at Woolston. Following the relocation of shipbuilding activities in 2004, the quay became integral to a major commercial and residential redevelopment of the area.

As part of the early enabling works, significant deterioration was identified within the quay structure, including cracking, spalling and corrosion. CRL was appointed to undertake essential structural repairs and to install a sacrificial anode system, extending the service life of this historically important marine asset.

Services undertaken

  • Remedial sealing of deck movement joints using bitumastic compound

  • Epoxy resin injection to seal cracks in concrete deck

  • Application of corrosion inhibitor to deck surfaces

  • Hydrodemolition to remove defective concrete from beams and soffits

  • Design and installation of fixed hanging scaffold above high tide level

  • Installation of sacrificial anode cathodic protection system

  • Welding of aluminium alloy anodes to steel sheet piles at low tide

  • Hydro-blasting of steel sheet piles above mid tide level

  • Application of protective bitumen coating to steel sheet piling



Tailored tools for every job

The condition of Centenary Quay required a comprehensive and technically coordinated intervention addressing both reinforced concrete and steel elements in a challenging tidal environment. Cracking and spalling were evident to the concrete beams and soffits beneath the deck, water ingress was occurring through the deck slab, and corrosion had initiated to the steel sheet piled wall. CRL developed a repair methodology that combined deck waterproofing, concrete repairs and long-term corrosion protection.

Works commenced on the top deck with remedial repairs to existing movement joints. This involved planing out a 450 mm wide strip along the joints and installing a bitumastic compound to reseal the deck and prevent further water ingress. Cracks within the deck were sealed using epoxy resin injection, restoring continuity and reducing pathways for moisture and chlorides. A corrosion inhibitor was then applied across the entire deck surface to provide additional protection to the embedded reinforcement.

To the underside of the quay, defective concrete was removed using hydrodemolition, allowing precise breakout without damaging sound material or reinforcement. Reinstatement was carried out using sprayed concrete, restoring the original profile and structural capacity of the beams and soffits. Access for these works was achieved through the design and installation of a fixed hanging scaffold positioned above high tide level, enabling safe and efficient working throughout the tidal cycle.

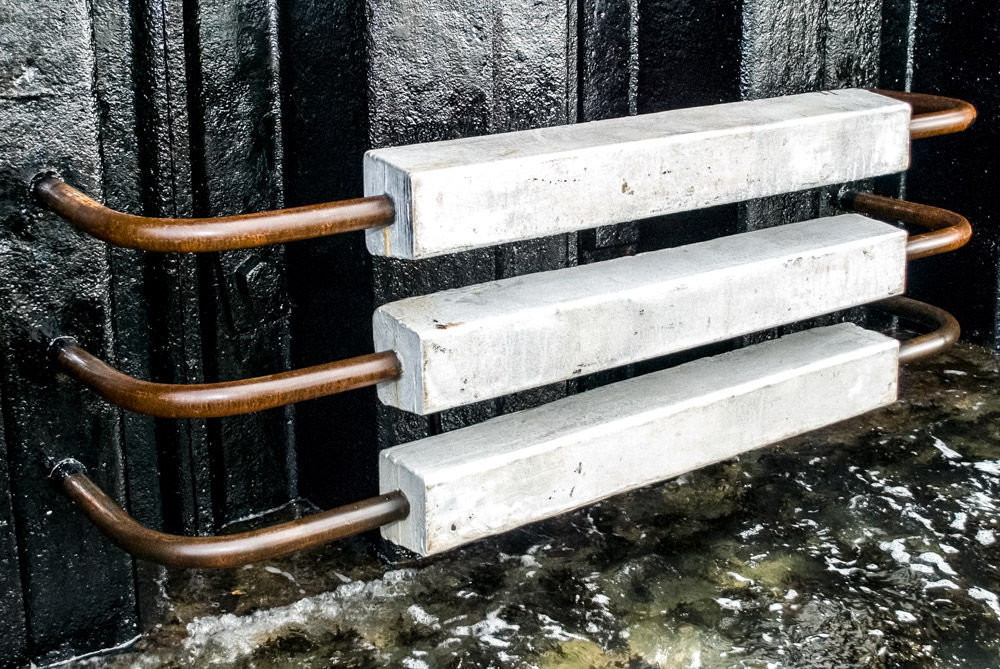

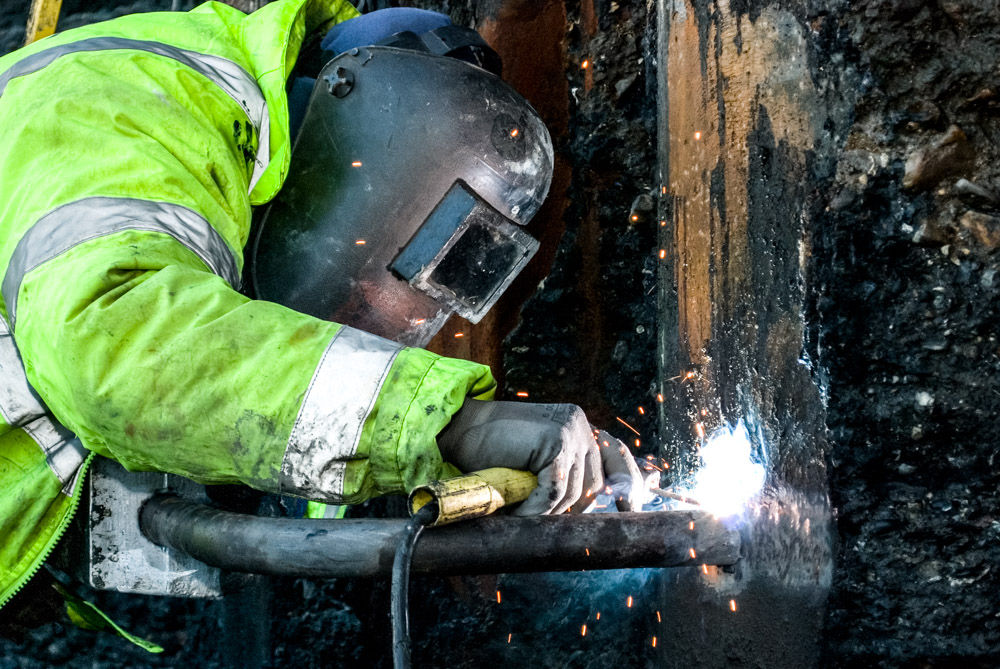

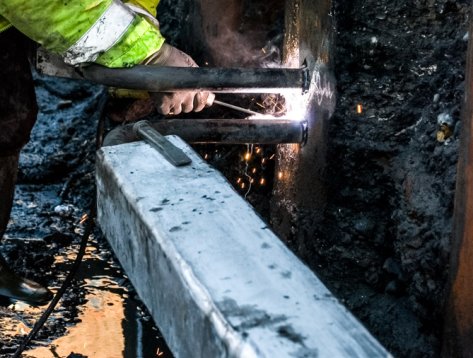

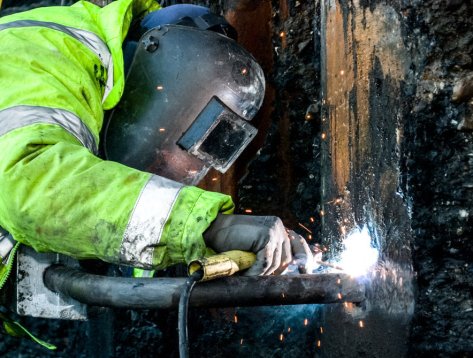

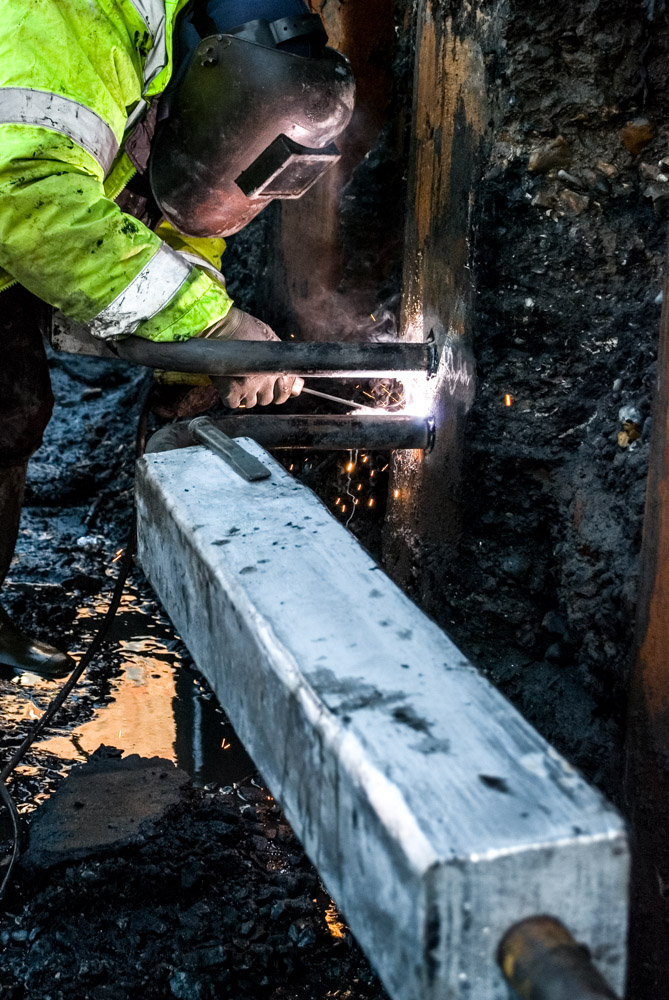

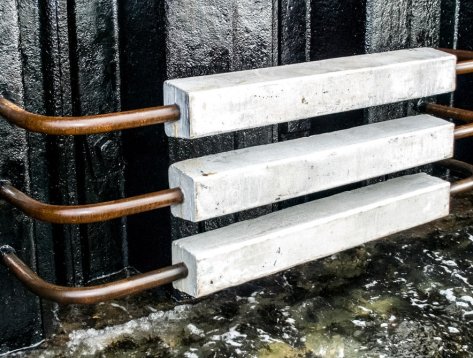

A key element of the project was the introduction of a sacrificial anode cathodic protection system to arrest corrosion of the steel sheet piled wall. Along the length of the quay, 280 aluminium alloy anodes, each weighing approximately 40 kg, were welded to the sheet piles during low tide when the mud level was exposed. Above mid tide level, the sheet piling was hydro-blasted to remove corrosion products and prepared for the application of a protective bitumen coating. This integrated approach demonstrates CRL’s expertise in complex marine concrete repairs and structural repairs UK, delivering durable solutions aligned with long-term asset management objectives.

“With only a short daily working window due to the tidal nature of the work, CRL were able to work systematically and efficiently to safely install the sacrificial anode system within programme constraints.”

Ken Buchanan | Site Manager | BAM Nuttall Ltd

Long-term preservation was fundamental to the Centenary Quay works. Deck sealing, crack injection and the application of corrosion inhibitors significantly reduce water and chloride ingress, protecting the reinforced concrete elements from further deterioration. Hydrodemolition and sprayed concrete reinstatement ensure high-quality repairs with strong bond characteristics and long-term durability.

The sacrificial anode system provides ongoing cathodic protection to the steel sheet piles below mid tide level, slowing corrosion rates and extending structural service life without the need for continuous power or complex monitoring. Protective coatings applied above mid tide level further enhance resilience. Collectively, these measures reduce future maintenance requirements, improve structural reliability and preserve the quay for continued use within the redevelopment, safeguarding a historically significant asset for future generations.

Protection beyond the repair
